Shakespeare Tunnel Works
By October 2003, the ‘’Strategic Rail Authority’’ (SRA) had formalised proposals for running high-speed commuter services between the capital and Kent, by means of the CTRL. The initial destinations to be served were outlined as follows:
Ashford
Canterbury West
Folkestone
Medway Towns
Ramsgate
The Port of Dover was
at this stage ruled out, since physical restrictions presented by the Gothic
bores of Shakespeare Tunnel violated existing safety criteria. The fact that
each track of the double line was accommodated in a wholly separate – and slim –
bore meant that very little room existed between the tunnel walls and the side
of a train. Thus, should a formation break down within the tunnel, passengers
could not physically escape via the conventional side doors of the train,
because there would be no room to open them out. As far as existing ‘’main
line’’ Kent Coast stock was concerned, this problem was eliminated by the
presence of end gangway connections. Thus, should a unit become stranded within
one of the single bores, passengers could still exit through either end of the
train. However, the proposed high-speed domestic stock was to feature
streamlined ends. It had been made clear early on in the design process that end
gangway connections would not be suitable for the high speed running planned. By
October 2004, the stage was set, and on 27th of that month, the Government
formally approved high-speed domestic services – by this time, Gravesend and
Sittingbourne had been added to the location list, but Dover was still lacking.
Twenty-eight 140 MPH six-vehicle units were to be ordered from Japanese firm
Hitachi at a cost of £250 million.
During 2006, there was a change of heart on the decision to deny Dover of a
high-speed rail service. A solution was devised for the safe operation of the
new units through Shakespeare Tunnel, involving converting passageways between
the two tunnel bores into ''evacuation points''. On 29th July, Dover was
formally included within the high-speed timetable and, as a consequence, a 29th
high-speed unit was added to the rolling stock order. £1.1 million had already
been spent on Shakespeare Tunnel in April 2004, this having seen the laying of
1,394 yards of continuously welded rail within the bores. 1,941 concrete
sleepers were also laid in the process, in addition to 1500 tonnes of ballast.
The latest task at the site, to create evacuation passageways, was begun on 25th
July 2009 and was scheduled to end on the 30th of the following month. 2006 was
an interesting year for the Channel Port, for at this time, the South East
England Development Agency (SEEDA) published plans to reconnect the Western
Docks to the railway network. Freight traffic was very much the theme of this
proposal, and it was suggested that the Western Docks spur could reduce port
congestion, providing an alternative mode of transport and taking much pressure
off the Eastern Docks. Furthermore, the running of CTRL domestic services
through to the cruise terminal (the former Western Docks station) was also seen
as having potential. The estimated cost of this scheme was £4.7 million, funding
provided partly by the Dover Harbour Board, SEEDA, and a mixture of EU bodies.
At the time of the plans, it was hoped that work would be completed by 2011.
1961
We first start with a bygone view from 1961, showing a Type 3 (Class 33) diesel exiting one of the gothic tunnel
portals with a Charing Cross service. The third rail in the foreground indicates that electrification is imminent.
© David Glasspool Collection
21st July 2009
On the night of 21st July 2009, a team set out with Class 395 No. 395008 to inspect some of the cross passageways
within Shakespeare Tunnel, which will be converted to ''evacuation points''. This sequence of photographs has kindly
been submitted by Paul Cooper-Hayden for inclusion, and the above view shows just how close the walls come to
the side of a passing train. Paul Cooper-Hayden
21st July 2009
In view is one of the shafts which leads to the sea. In the foreground, the track shows the effects of coastal
conditions. Paul Cooper-Hayden
21st July 2009

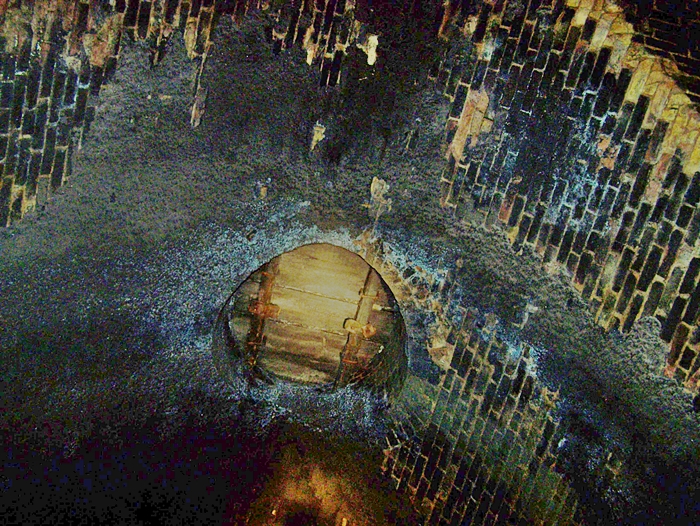

Now turning our attention to the ceiling, we observe a vent shaft and the tunnel's brick lining. Neighbouring
Abbottscliffe and Harbour Tunnels are also undergoing surgery, the pair having their linings reinforced and
drainage improved. Paul Cooper-Hayden
